Views: 9 Author: Site Editor Publish Time: 2026-04-01 Origin: Site
Quick Answer:
Display lead times are long mainly due to complex multi-component supply, precision manufacturing processes, structured production scheduling, upstream material constraints, and incomplete project validation.
In custom display projects, even a single material delay, process bottleneck, or scheduling disruption can impact the entire delivery timeline. Stable lead time depends on early planning, supply chain coordination, and controlled production execution.
In the manufacturing industry, lead time is always a sensitive topic. We often hear the same question from customers:
“How long will this display take?”
But in reality, by the time this question is asked, the timeline is often already tight.
The truth is—no manufacturer wants delays. Every factory aims for smooth and predictable delivery. But in the display industry, especially in custom touch display projects, lead time is influenced by multiple factors that are not always visible from the outside.
Here, we’d like to walk through the real reasons behind “long lead times” from a manufacturer’s perspective.

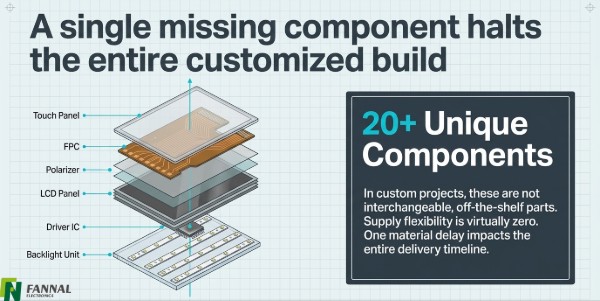

A display module may look compact, but its structure is highly complex.
A typical module includes:
LCD panel
Driver IC
Polarizer
Backlight unit
FPC
Touch panel (optional)
In total, nearly 20 different components are involved.
For companies like FANNAL, most projects are customized, not off-the-shelf. This means:
Materials are not interchangeable
Supply is not always flexible
Any single component delay can hold up the entire order
To reduce uncertainty, we bring key processes in-house:
Display side: panel cutting & cleaning, SMT, bonding, assembly, aging
Touch side: sensor design, production, and lamination
This reduces dependency on external suppliers and improves control over quality and timing.
However, tighter control also means higher cost. In a differentiated market, stability always comes before cost.

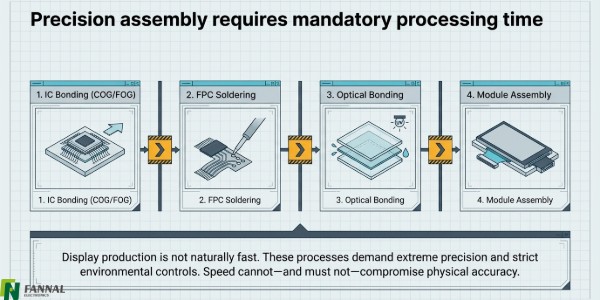

Display production is not fast by nature.
Processes such as:
IC bonding (COG/FOG)
FPC soldering
Module assembly
all require high precision and strict inspection control.
At multiple stages, 100% inspection is required, including:
After glass processing
After polarizer lamination
After bonding
Before and after optical bonding
Before shipment
Not all steps can rely on AOI. Many still require manual inspection, which is time-consuming but necessary.
Every step is designed to eliminate risk before delivery, not after.
From a customer perspective, inserting an urgent order may seem simple.
From a factory perspective, it is not.

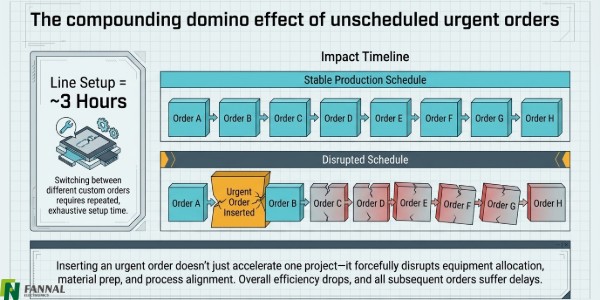

Production planning is the central coordination system of manufacturing. Once a schedule is set:
Equipment is allocated
Materials are prepared
Processes are aligned
In our case:
A production line setup takes around 3 hours
Switching between orders means repeated setup time
If an urgent order is inserted:
Existing schedules are disrupted
Efficiency drops significantly
All other orders are affected
That’s why factories generally avoid urgent changes.
However, since we serve high-mix, low-volume customized markets, we’ve built:
Multiple fully automated lines for stable production
Additional semi-automated lines for samples and urgent small batches
This allows us to handle urgent requests without completely disrupting the system.

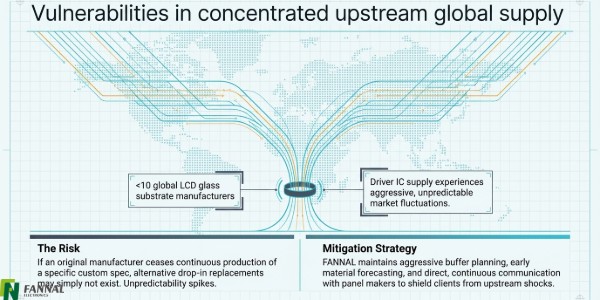

The display industry relies heavily on upstream suppliers.
For example:
Fewer than 10 companies globally produce LCD glass substrates
Driver IC supply can fluctuate
Certain custom specs may not have continuous production
If the original manufacturer stops supplying a specific material:
Alternatives may not exist
Lead time becomes unpredictable
To manage this risk, we:
Maintain close communication with panel makers and distributors
Monitor supply conditions regularly
Align with customers early on material planning
For critical projects, forecasting and buffer planning are essential.

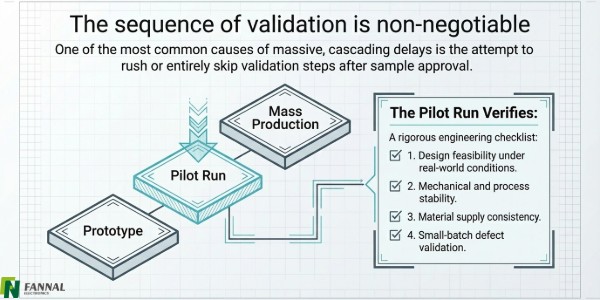

One of the most common issues is rushing the process.
In some projects:
Sample approval is quickly followed by mass production
The pilot run (trial production) is skipped
This creates significant risk.
The purpose of a pilot run is to verify:
Design feasibility
Process stability
Material consistency
Small-batch validation
Skipping this step often leads to:
Yield issues
Rework
Delivery delays
For such cases, we set up cross-functional project teams, involving:
Engineering
Process
Quality
Procurement
Sales
to closely monitor production and reduce uncertainties.
From our experience, lead time issues are often avoidable with better planning:
1. Plan earlier internally
Don’t wait until production is about to start to place the display order.
2. Keep communication active
Don’t place an order and wait silently. Ongoing updates help identify risks early.
3. Allow realistic production time
Rushing the process may save time initially, but often leads to greater delays later.
We fully understand how critical lead time is.
At FANNAL, we don’t treat “long lead time” as an excuse. Instead, we continuously optimize our internal processes while maintaining strict quality control.
Our goal is simple:
Deliver fast — but more importantly, deliver reliably.
